Beijing has stopped counting the money; now it is working out how to spend it better
The 2026 Two Sessions confirms a shift in Beijing’s fiscal thinking. After the sharp expansion of 2025, the question is no longer how much to spend but how to spend it wisely. The deficit ratio holds at 4 percent, general public budget expenditure edges up to C¥30 tn, and local special bonds are broadly flat at C¥4.4 tn. After a sharp step-up in 2025, they are now on a high plateau. What has changed is the logic governing which projects get funded and whether the money actually gets out of the door.

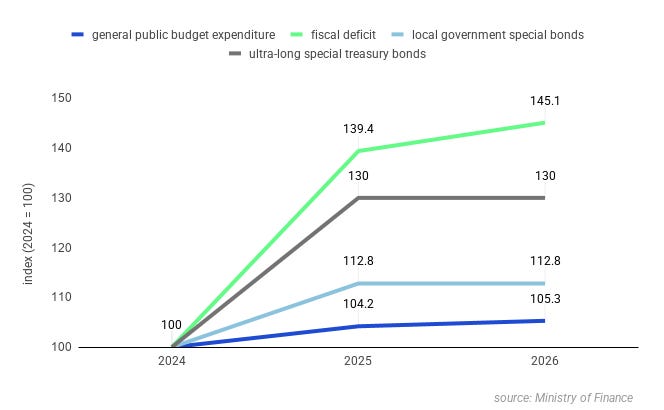

fiscal toolkit stepped up in 2025 and held at a high plateau in 2026
from more spending to structured delivery
Beijing is not stepping back from investment-led support in 2026, but nor is it simply reverting to the earlier model of fragmented, locally driven expansion.
This shift builds on dynamics already visible in 2025. The package looked expansionary on paper, but general public budget expenditure fell short of the target, and both total fixed asset investment and private investment were in contraction by year-end. That helps explain why policymakers do not appear to view a further increase in headline fiscal numbers as sufficient to generate a broad or durable upswing.
What stands out in 2026 is a reworked delivery model. The centre is taking on a greater stabilisation role, with local budgets held broadly flat and a deliberate rebalancing of who bears the fiscal weight. At the same time, the investment universe is widening: the 2026 Government Work Report links ‘effective investment’ not just to traditional infrastructure but to new productive forces, new urbanisation and human development.
Three funding channels; three distinct jobs
central budget investment of C¥755 bn plugs gaps and supports weaker-return project
C¥800 bn in special long-term bonds ring-fenced for nationally strategic and security-critical projects
expanded C¥800 bn policy-finance tool acts as project capital, crowding in matching finance and social capital
The real shift in 2026 is how support is structured and delivered, consistent with the lower, more flexible GDP target set for the year. In this sense, the 2026 fiscal stance is not only about scale, but about better-targeted spending and stronger fiscal-financial coordination, notes Luo Zhiheng 罗志恒 chief economist and Chao Yunxia 晁云霞 macro analyst, Yuekai Securities.
Policy coordination matters as much as scale. The goal is coordinated division of labour across channels, built around a common project pipeline to cut fragmentation and accelerate delivery.
A new C¥100 bn fiscal-financial coordination fund for domestic demand adds a further layer. The NDRC pre-allocated funding for 2026 projects at the end of 2025, with the explicit aim of accelerating starts and forming physical workload sooner.

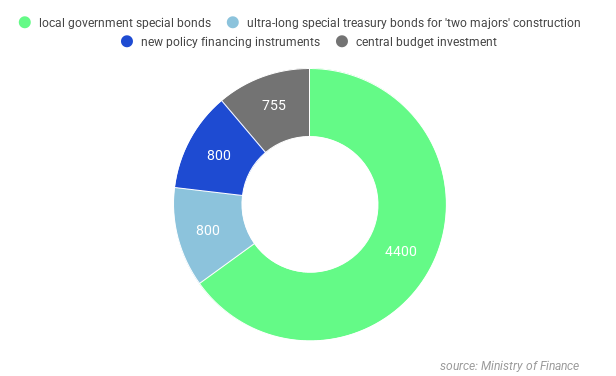

2026 effective-investment support toolkit (C¥ bn)
note: These channels do not map one-for-one into infrastructure capex, as local special bonds are also used for debt management and clearing arrears.
The logic of this shift reflects what the 2025 investment data had already begun to show. There was no broad-based infrastructure boom. Utilities, network and system segments held up, but strip those out and infrastructure investment fell over the full year. The cycle is tilting toward equipment-intensive, network-oriented, system-upgrading projects and away from concrete-heavy expansion.
2025 fixed-asset investment growth by sector
This also helps explain the role of private capital. Policy language still points to broader participation, but the realised pattern of investment suggests that the near-term buildout remains more state-led than that rhetoric implies.
With private investment weakening through 2025 and state-backed projects holding up, the likely carriers of the next buildout are the parts of the state system with funding capacity, planning authority and implementation reach—not a broad private revival or local spread.
where future projects lie
The 15th 5-year plan draft, released on 4 March, provides a clearer framework for the more differentiated delivery model emerging in 2026. One of the notable signals is the emphasis on the ‘six networks’: water, power, computing, new communications, urban underground utility and logistics. In transport, the focus is on strategic corridors and nodes, the ‘eight vertical and eight horizontal’ high-speed rail grid, national expressways, major port clusters and airport groups.
This points to a shift in the logic of infrastructure: away from broad locally driven buildout and towards national networks, resilience and coordination, with favoured projects being those that strengthen these national networks, raise system resilience, support industrial upgrading or ease visible public-service bottlenecks.

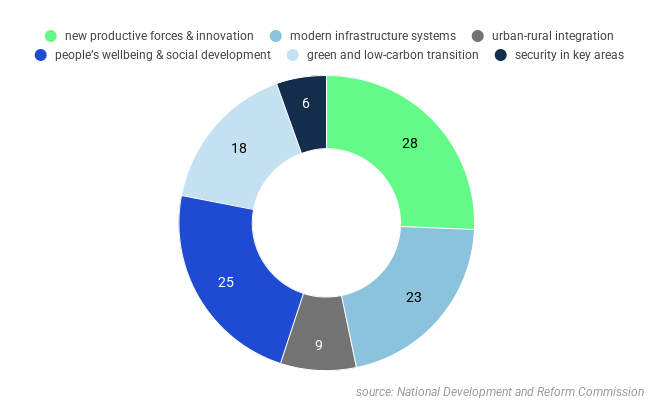

The project universe is also becoming more concrete. The plan’s 109 major projects include 23 under modern infrastructure systems. Investment in integrated transport, low-altitude infrastructure, AI+, education and medical facilities and related fields in 2026 is preliminarily estimated at more than C¥7 tn, according to Zheng Shanjie 郑栅洁 NDRC director.
Better coordination, phased rollout and alignment between digital and physical infrastructure systems, not overbuilding, is what ‘appropriately ahead of demand’ means in practice, notes Zhang Haiyi 张海懿 CAICT (China Academy of Information and Communications Technology) DG.
The C¥7 tn-plus figure spans fiscal, quasi-fiscal and state-led channels, and should be read as a policy-guided investment universe rather than a narrow fiscal-spending line. Central SOEs completed C¥5.1 tn of fixed asset investment in 2025 alone; State Grid plans roughly C¥4 tn over the 15th 5-year plan period. The current buildout is increasingly a state-system capital spending story, not a budget story.
The clearest hard anchors sit in energy and digital infrastructure
around 100 GW of new pumped-storage capacity
offshore wind above 100 GW
nuclear operating capacity around 110 GW
west-to-east power transmission above 420 GW
1 mn 50G PON ports and 500,000 5G-A base stations
selective pool of 109 national projects outlined in 15th 5-year plan
Beijing has stopped reaching for bigger numbers. The 2026 bet is that a tighter, more centralised investment regime can do what headline expansion could not. Scale had its moment. Now what is needed is discipline and centre-local joined-up thinking.
